Does GROW with SAP Include SAP EWM? What Growing Enterprises Actually Get

Supply Chain Junction article header, Manhattan Associates GeoPartner for Africa and the Middle East

No. GROW with SAP delivers SAP S/4HANA Cloud Public Edition, where the warehouse capability is called Warehouse Management — which SAP describes as based on EWM but with a smaller functional scope. Advanced SAP EWM is available only on S/4HANA Cloud Private Edition or on-premise.

That distinction decides what your warehouse can do for the next decade, and most growing enterprises never see it. The warehouse is one line in a much larger ERP programme, the names are nearly identical, and nobody runs a separate warehouse evaluation. This article sets out what each path actually delivers, what it costs to change your mind later, and what the alternative now looks like.

What is GROW with SAP?

GROW with SAP is SAP's route to market for growing enterprises. Launched in 2023, it packages SAP S/4HANA Cloud Public Edition with preconfigured best-practice processes, guided implementation and learning resources, and it is delivered through regional partners rather than the global integrators that handle RISE with SAP. SAP has said that midsize companies make up more than 80% of its customer base, so this is not a side project.

SAP has since added a faster, more prescriptive variant aimed at go-live in weeks. As an ERP proposition it is credible: fast to stand up, standardised, subscription-priced, with a defined release cadence. Nothing below is an argument against GROW as an ERP. The argument is about what comes with it for the warehouse.

What warehouse capability does S/4HANA Cloud Public Edition include?

It includes a capability called Warehouse Management. SAP's own learning material describes it as based on EWM but with a smaller functional scope. It is a genuine warehouse capability — it handles inbound and outbound delivery, warehouse tasks and orders, storage bins, physical inventory and stock — and SAP continues to extend it each release.

What it is not is SAP Extended Warehouse Management. Those are two different things with confusingly similar names:

  • Warehouse Management — in S/4HANA Cloud Public Edition, included in the subscription, reduced functional scope.
  • SAP EWM — available on S/4HANA Cloud Private Edition or on-premise, deployed embedded or decentralised, with the advanced warehouse functions SAP positions against specialist WMS vendors.

The EWM-related scope items in Public Edition exist to integrate it with an EWM system running somewhere else. Since the 2508 release in August 2025 there is a dedicated one — SAP EWM for SAP S/4HANA Integration (7L1) — which connects Public Edition to a decentralised EWM running on S/4HANA Cloud Private Edition. That is worth knowing, and it does not change the underlying position: the integration exists precisely because advanced EWM does not run inside Public Edition.

How do you get advanced EWM, and what does it cost to get there?

Two steps, and both are larger than they sound. First, you change ERP deployment. Advanced EWM is not available in Public Edition, so reaching it means moving to S/4HANA Cloud Private Edition — a different deployment of the ERP, not a switch you flip. If you adopted Public Edition specifically because it was standardised and quick, this undoes that decision.

Second, you license and implement it. On Private Edition the basic EWM functions sit inside the subscription, while the advanced functions carry an additional licence. Then you run an EWM implementation: design workshops, development, integration testing, data migration. SAP's EWM documentation sets out what each deployment supports.

So the honest sequence for a growing enterprise that outgrows the bundled warehouse is: replatform the ERP, license the advanced functions, implement a second warehouse product. None of that is visible at the point you signed.

Why this decision is being made right now

The calendar is driving it. SAP ECC mainstream maintenance for enhancement packages 6 to 8 ends on 31 December 2027, and for packages 0 to 5 it already ended at the end of 2025. The compatibility window for classic LE-WM inside S/4HANA closed at the end of 2025 as well.

Every company still on ECC is inside the decision window now. That matters because it sets the conditions under which the warehouse choice gets made: under time pressure, inside an ERP programme, with the warehouse as one line item among hundreds. It is close to the worst possible circumstance in which to choose a system your operation will live in every day for ten years.

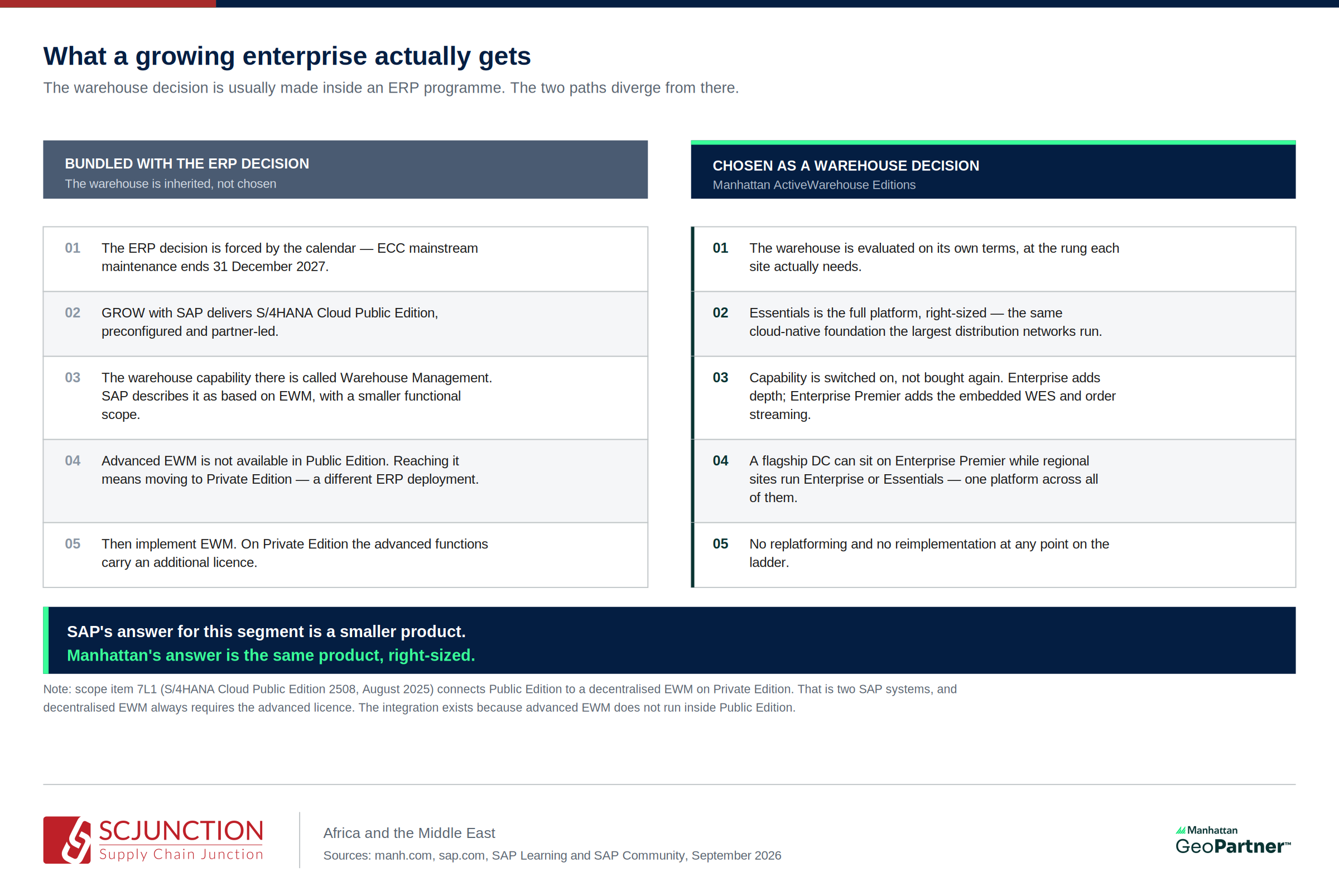

Two paths to a warehouse system for a growing enterprise: bundled with the SAP ERP decision, where S/4HANA Cloud Public Edition provides Warehouse Management rather than advanced SAP EWM, against choosing a warehouse system directly with ActiveWarehouse Editions

What changed on the other side of the comparison

Until recently there was a good reason growing enterprises accepted the bundled warehouse: the alternative was out of reach. A specialist Tier-1 WMS meant a bespoke configuration programme measured in quarters, at a licence cost that only amortised across a large network. The software could always handle a 40,000-pallet operation. The commercial model could not.

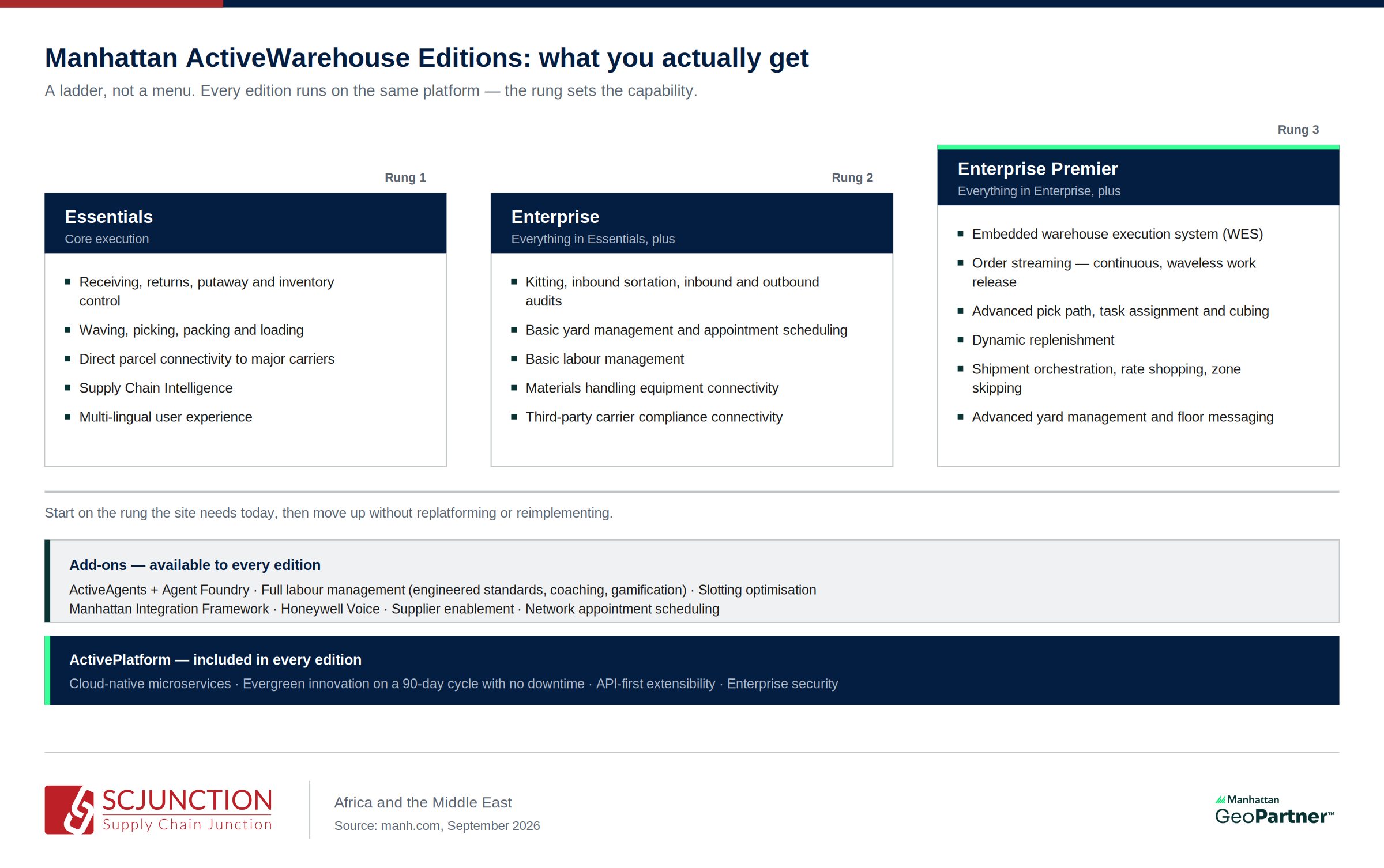

Manhattan changed that model. With Editions for Manhattan Active® solutions, ActiveWarehouse™ now ships in three editions — Essentials, Enterprise and Enterprise Premier. Manhattan's CEO Eric Clark described the structure as "a ladder, not a menu of different products," and the distinction matters: this is a change to packaging, not a separate or smaller product.

ActiveWarehouse Editions compared — what Essentials, Enterprise and Enterprise Premier each include, the add-ons available to every edition, and the shared ActivePlatform foundation

Essentials runs the same cloud-native microservices platform, the same unified data model, the same API-first extensibility and the same 90-day release cycle with no downtime as Enterprise Premier. Fewer capabilities are switched on. Nothing has been rebuilt in a lesser form.

Which produces the contrast that matters here. SAP's answer for this segment is a smaller product. Manhattan's answer is the same product, right-sized. Climbing from Essentials to Enterprise to Enterprise Premier switches capability on — there is no second product, no replatform and no reimplementation anywhere on that ladder.

Be clear about where the capability sits, because this cuts both ways. The embedded warehouse execution system and order streaming are Enterprise Premier capabilities. Full labour management, slotting optimisation and ActiveAgents with Agent Foundry are add-ons at every rung — and most small and mid-sized operations genuinely do not need them. If your business case depends on any of them, specify them at the start rather than discovering them later, which is precisely the mistake the bundled path invites.

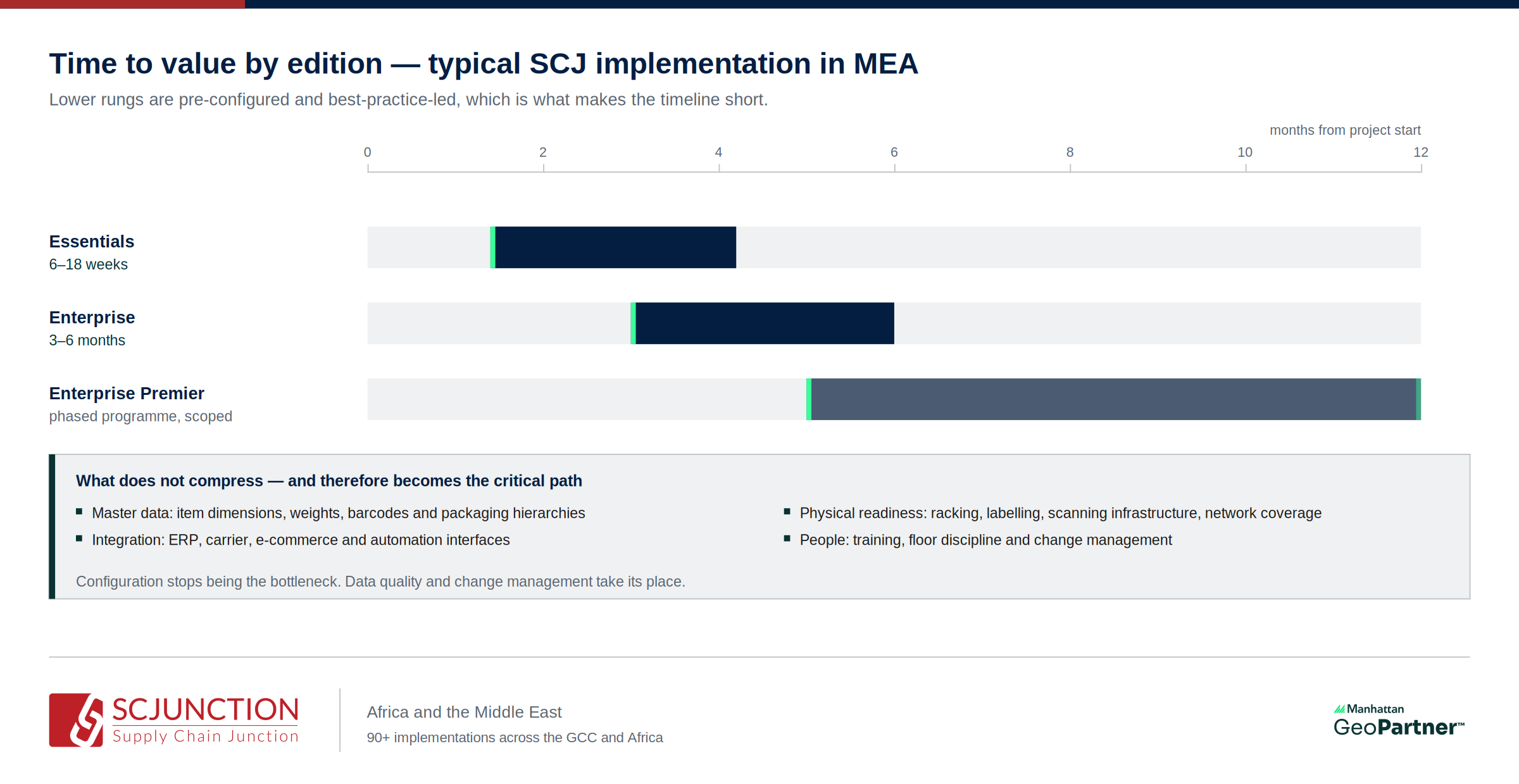

How long does each path take?

A first ActiveWarehouse site typically takes 6–12 months from design start to stable operation, and scope moves that figure more than the edition does. We set out what drives it in What Does a Manhattan ActiveWarehouse Implementation Cost, and How Long Does It Take?

Five questions to ask before you sign

  1. Does this proposal cover Warehouse Management in Public Edition, or advanced SAP EWM? Ask for it in writing. The names are close and the capability is not.
  2. If we outgrow it, what is the path? Specifically: does reaching advanced EWM require moving to Private Edition, and what does that cost in licence, services and elapsed time?
  3. Which advanced functions sit inside the subscription and which are licensed separately?
  4. What throughput, channel mix and automation are we assuming? The bundled warehouse is usually sized against today's operation, not the one in the business plan.
  5. Has the warehouse been evaluated on its own terms at all? If the answer is that it came with the ERP, that is not an evaluation.

Which path fits

If your warehouse processes are standard and SAP-shaped, your volumes are stable, automation is not on the roadmap, and keeping everything inside one SAP landscape is worth more than warehouse depth — the bundled capability may genuinely be sufficient. Plenty of operations run well on it.

If you are running retail compliance requirements, a growing e-commerce channel, multi-site or multi-country flows, third-party logistics for clients on different ERPs, or any automation beyond a conveyor — the gap between a reduced-scope warehouse capability and a specialist WMS will find you, and it will find you after go-live.

If you want the head-to-head comparison rather than the bundling question, we have written that up separately in Manhattan vs SAP EWM vs Infor vs Oracle: which WMS fits MEA warehouses?

The change worth knowing about is that this is now a real choice. For the first time, a growing enterprise in Riyadh, Dubai, Jeddah or Johannesburg can weigh the warehouse system on its own merits at a subscription level and a timeline that a single-site business case can carry.

Supply Chain Junction is the Manhattan Associates GeoPartner for Africa and the Middle East, with consultants based in the GCC and South Africa and 90+ implementations across the GCC and Africa. Working out which rung your operation sits on is a twenty-minute conversation, not a research project. Book a short call.

Frequently asked questions

Does GROW with SAP include SAP EWM?

No. GROW with SAP delivers SAP S/4HANA Cloud Public Edition, where the warehouse capability is called Warehouse Management and is described by SAP as based on EWM with a smaller functional scope. Advanced SAP EWM is available only on S/4HANA Cloud Private Edition or on-premise.

What is the difference between Warehouse Management and SAP EWM?

They are different products with similar names. Warehouse Management in S/4HANA Cloud Public Edition is included in the ERP subscription and carries a reduced functional scope. SAP EWM runs on Private Edition or on-premise, can be deployed embedded or decentralised, and provides the advanced warehouse functions — including the Material Flow System for automation control. On Private Edition, the basic EWM functions are in the subscription and the advanced functions require an additional licence.

Can I connect S/4HANA Cloud Public Edition to SAP EWM?

Yes. Scope item 7L1, SAP EWM for SAP S/4HANA Integration, was introduced in the 2508 release in August 2025 and connects Public Edition to a decentralised EWM running on S/4HANA Cloud Private Edition. Note what that means commercially: you are running two SAP systems rather than one, and decentralised EWM always requires the advanced EWM licence.

Can I add SAP EWM to S/4HANA Cloud Public Edition later?

Not inside Public Edition. Advanced EWM runs on Private Edition or on-premise, so adding it means changing ERP deployment and then implementing EWM. The EWM-related scope items in Public Edition exist to integrate it with an EWM system running elsewhere, not to enable EWM within it.

Is Manhattan only for large enterprises?

Not since ActiveWarehouse moved to three editions. Essentials is the same cloud-native platform as Enterprise Premier with fewer capabilities switched on, and an operation can climb to Enterprise or Enterprise Premier later without replatforming or reimplementing. The deciding factor is how much complexity your operation genuinely carries, not its size.

When does SAP ECC support end?

Mainstream maintenance for SAP ECC on enhancement packages 6 to 8 ends on 31 December 2027, with optional extended maintenance available beyond that. For enhancement packages 0 to 5 it ended on 31 December 2025. The compatibility window for classic LE-WM within S/4HANA closed at the end of 2025.

How long does a Manhattan ActiveWarehouse implementation take?

A first site typically takes 6–12 months from design start to stable operation; scope moves that figure more than the edition does. Master data preparation, integration, physical site readiness and change management do not compress, and become the critical path.
